Skip to content
ONE PROPERTY. YOUR PROPOSED USE.

What will the
land allow?

Before you commit, know the place.

Bring us a property
See how the next site becomes a decisionREALCLEAR / FIRST READ
THE QUESTIONS THAT COULD CHANGE THE PLAN
00:00 / 00:16
SCROLL TO EXPLORE ↓
THE SHIFT A deep dig on one candidate at a time becomes a cited first read on each. Look at more places before you commit to one.
BEFORE THE EXPENSIVE COMMITMENT

Know what to resolve
before you commit.

Before a lease, land purchase, design commission or deeper diligence, identify the rule, site constraint or missing evidence that could change the plan.

Retained rules and cited case files provide a head start. Every new property still needs its own parcel, proposed use, current rule and supporting passage checked.

How a finding stays tied to a source ↗

18 MAR 2025 · LOUDOUN COUNTY · BOARD OF SUPERVISORS

Data centers now need a Special Exception in the IP, GI and MR-HI districts.

The question for this parcel

Which district is the parcel in, and does any grandfathering provision apply?

Answer you can trace

A data center in IP, GI or MR-HI now needs Special Exception approval. Confirm the parcel’s district and whether a grandfathering provision applies to it.

THE WORK, MADE VISIBLE

A place. A proposal.
An answer you can trace.

Follow one data-center question from the exact site to the person who has to make the next call.

ONE DATA-CENTER QUESTION

01 / THE STARTING POINT

Are we looking at the exact site?

An address, a parcel number, coordinates or a pin: whatever you bring resolves to one parcel. The parcel, study area and proposed use then stay attached to every question, so a rule about somewhere else never becomes an answer about the plan.

The place and the proposal stay together.

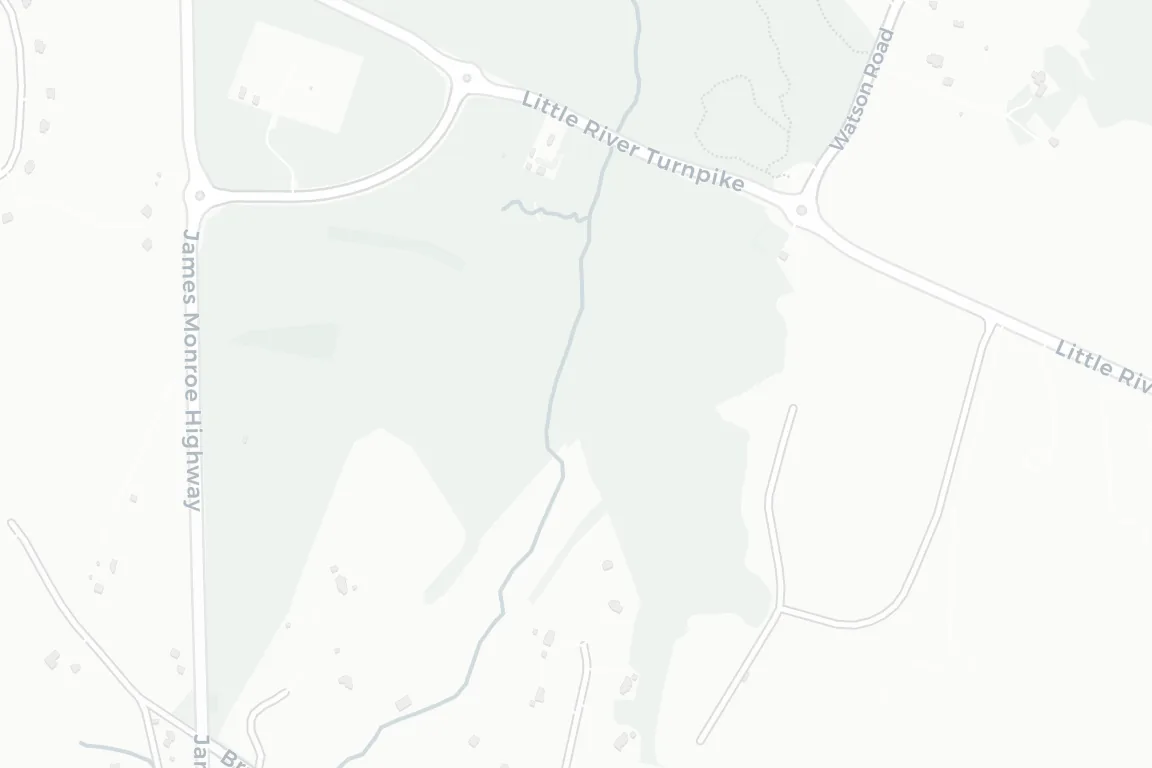

Map of roads and waterways in the Loudoun County study area
01 / LOCATE THE SITELOUDOUN COUNTY / VA
STUDY AREA
© OpenStreetMap contributors © CARTO
01 → 02 / THE SITE BECOMES THE INQUIRY
One parcel. One proposed use. SCOPED
02 / THE RESEARCH START

Which records do different jobs?

The use table frames permission. Site and mapped records frame the physical question. A utility response establishes whether the proposed load and timing can be served. Each source has a job; none can stand in for another.

Research the gap that could actually change the plan.
RESEARCH / THE OPEN QUESTIONSFrom scattered records to a scoped inquiry
01
Land-use record

Which approval path applies to this parcel and use?

RULE
02
Mapped site context

Where are the visible water and access questions?

PLACE
03
Provider response

Can the intended load and schedule be supported?

SERVICE
INQUIRY QUEUECounty use tableLocate governing rule
RESEARCH STEPS
COUNTY CODEOpening the county land-use table for the industrial districtsLOCATED
COUNTY CODE28 candidate zoning records; reading the 5 that name data-center usesREAD
COUNTY ACTIONDated board action: Special Exception now required in IP, GI and MR-HILOCATED
SITE MEMOApproval path changed; the parcel's own district still to confirmNOTED
GIS LAYERLoading parcel outline, hydrography and road centerlinesREAD
GIS LAYERMapped waterway along the north edge; setback question loggedNOTED
GIS LAYEREntrance geometry checked against the truck-turn templateREAD
SITE MEMOWater and access framed as questions to test, not findingsNOTED
PROVIDERLoad and timing question drafted for the provider requestNOTED
PROVIDERPublished service-territory map checked; no capacity figure on itREAD
PROVIDERNo written response on file; capacity stays an open questionOPEN
HEARING RECORDPlanning commission minutes located; two items touch this districtLOCATED
COMMENTS31 comments on file; support and concerns listed to verifyREAD
SITE MEMOOpen questions moved into the site memo with their sourcesNOTED
02 → 03 / THREE FINDINGS, WITH THEIR LIMITS
County action READ
Parcel district TO VERIFY
Provider response OPEN
03 / THE PROOF

What does the record support?

The dated county action establishes a changed approval path. The actual parcel district and application history decide what to check next. The source, supported finding and open question stay together.

Click through the evidence chain.
FOLLOW ONE FINDING18 MAR 2025 / LOUDOUN COUNTY
THE DATED SOURCE
“requiring Special Exception (SPEX) approval for data center uses in the Industrial Park (IP), General Industry (GI), and Mineral Resources-Heavy Industry (MR-HI) zoning districts.”

A March 18, 2025 county action gives the rule a date and a source.

Open the county record ↗
RECOMMENDATIONResolve first.

Parcel identity, the applicable approval path and provider evidence remain to be established.

03 → 04 / THE EVIDENCE SETS THE RECOMMENDATION
Resolve first. DECISIVE CHECKS OPEN
04 / THE WORKSPACE

A working view of the decision.

One property, one verdict and the short list that decides it. Each check names who closes it and the record that settles it; the next moves are the handoff, in order.

One shared starting record.See the workspace ↗
REALCLEAR / PROPERTY WORKSPACEDATA CENTER · LOUDOUN COUNTY, VA
Street view of an undeveloped industrial site
CANDIDATE SITE · INDUSTRIAL DISTRICT

Resolve first. Three checks still open.

The dated rule gives the team a direction. The parcel and service checks still determine the actual path.

Three checks before you commit
1
Special Exception path in the districtLand-use advisor · Loudoun County amendment, March 18, 2025
Located
2
A written provider response for the intended loadUtility lead · not yet on file
To verify
3
Waterway buffer along the north edgeDevelopment · mapped waterway, setback still to measure
Open
Three next moves
01 · This week

Confirm parcel district and application history.

Owner: development
02 · Before LOI

Test the approval path against the dated county action.

Owner: land-use advisor
03 · At LOI

Request a written response for intended load and timing.

Owner: utility lead
04 → 05 / THREE NEXT MOVES, THREE OWNERS
Confirm the parcel DEVELOPMENT
Test the approval path LAND-USE ADVISOR
Request provider evidence UTILITY LEAD
05 / THE HANDOFF

Who carries the next move?

The costly discovery is the one made after the site-control clock starts, the design team is hired or a lease is signed. The memo puts the unresolved questions in front of the people who can settle them while there is still room to change course.

Protect the next decision. Know who owns each answer.
REALCLEAR / SITE MEMODATA CENTER SCENARIO

Resolve first.

Confirm the parcel, approval path and provider evidence before a recommendation to proceed.

01 / DEVELOPMENTConfirm parcel district and accepted-application history.THE LAND
02 / LAND-USE ADVISORTest the approval path against the dated county action.THE RULE
03 / UTILITY LEADRequest a written response for intended load and timing.THE SERVICE
THE HANDOFF Three owners, one record. Each answer comes back to the same memo.
ANOTHER KIND OF PLACEWAREHOUSE STUDY / PIER 70

The building stays.
A new possibility opens.

Two distinct buildings ask the same four questions before a new use is proposed. The first is a Brooklyn warehouse study; the second is a real photograph of Pier 70, reimagined.

EXISTING BUILDING / POSSIBLE FUTURE
BROOKLYN WAREHOUSE STUDYA DESIGN STUDY
The records shape the second life.
01 / THE QUESTION

What could this
building become?

A place with history. A decision that needs more than a rendering.

00:00 / 00:14
Brooklyn warehouse study before a proposed reuseThe same warehouse after a proposed reuse
BROOKLYN WAREHOUSE STUDY · BEFORE / AFTER
September 2018 photograph of the Union Iron Works entrance at Pier 70A reuse concept drawn on the Pier 70 photograph, not an approved project
PIER 70 PHOTOGRAPH · BEFORE / CONCEPT
What must stay?What use fits?Can everyone enter?Who needs a say?
The same building. A new reason to enter.

Two separate studies: a Brooklyn warehouse study before and after a proposed reuse; then a September 2018 photograph of the Union Iron Works entrance at Pier 70 and a reuse concept drawn on that photograph, not an approved project. The four questions are: What must stay? What use fits? Can everyone enter? Who needs a say? The same building. A new reason to enter.

00:0000:0700:14
THE RECORD TO READ

Historic status, the current use table, accessibility and egress rules, and the hearing record for the block.

THE NEXT MOVE

Check which of those questions governs a proposed use before design money is spent.

Warehouse views are design renderings. Pier 70 source photograph: Union Iron Works entrance, September 2018, Pi.1415926535 / Wikimedia Commons, CC BY-SA 3.0. RealClear changed that photograph to depict a reuse concept; both Pier 70 stills are presented under CC BY-SA 3.0. The after image depicts no actual tenant or approved project.

PROPERTY SCENARIOS

A decision today.
A question worth following.

Explore six property scenarios: a starting condition, a possible future, and the question that could change a developer’s next move.

Explore the case files ↗
For a real property, the next move depends on its parcel and current record.
WHEN YOU HAVE A PLACE IN MIND

A place with potential.
Let’s put it to work.

Bring us the property and the use you have in mind. A first read comes back in a private workspace, every finding tied to its source.

Bring us a property ↗
